Project

DESIGN, CONSTRUCTION, OPERATION, MAINTENANCE, CONSERVATION AND EXPLOITATION OF A highway CALLED "NICOLÁS ROMERO – CUAUTITLÁN IZCALLI", "NORTH CONNECTION", IN THE STATE OF MEXICO.

Sector: Transport


Last Revision

December 04, 2023
Short Name of the Project:
0917 North Connection Highway
Type of Investment:
Greenfield
Subsector:
Highways / bridges
Asset (s):
 Highway 18.44 KM-A2
Contract Currency:
Mexican Pesos MXN
Estimated Investment MXN:

6,500,000,000

Estimated Investment USD:

380,116,959

Exchange rate (USD/MXN) used by the Ministry of Finance for the economic plan 2024: $ 17.1
Contract Scope:
  Design,  Construction,  Operation,  Maintenance,  Conservation,  Exploitation

DESCRIPTION

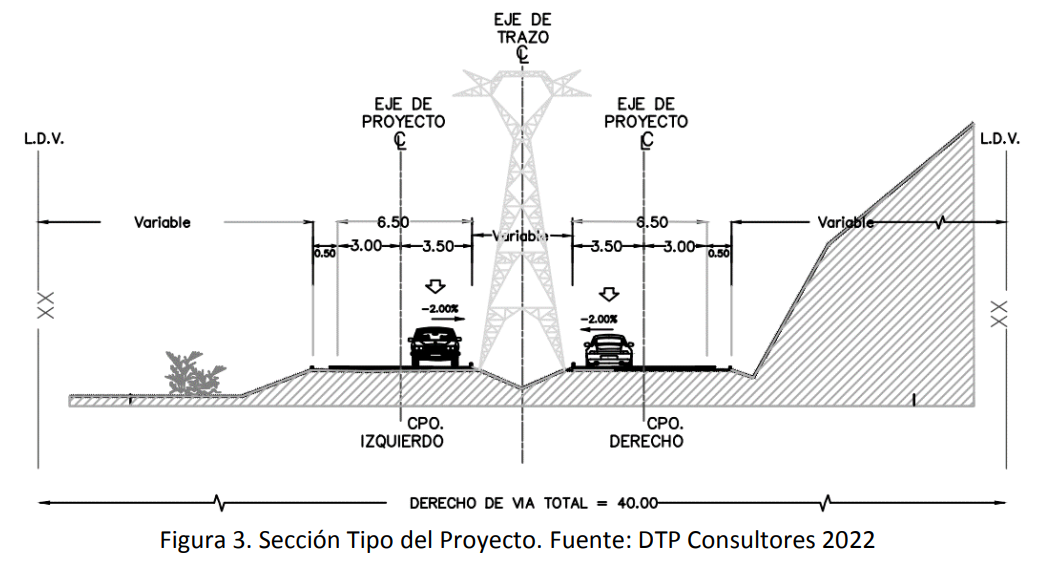

The project consists of the design, construction, operation, maintenance, conservation and exploitation of a road infrastructure, called "Nicolás Romero - Cuautitlán Izcalli", "North Connection", with two traffic lanes, one in each direction, with delimitation and the possibility of operate with 2 lanes of 3.50 meters in one direction, by means of one lane, with a project speed of 80 km/h, a governor slope of 4% and a maximum slope of 6%; the width of the road is 7 meters with a lane of 3.50 meters for each road body, in addition to two exterior boundaries of 3 meters on each side and an interior boundary of 0.5 meters.
Two sections will be built, separated by the CFE transmission line, with a total crown width of 14.00 meters. The maximum curvature is 5.5°. The Project is developed within a right-of-way width of 40 meters, with 20 meters on each side from the axis of the highway.

Characteristics:
- Length 18,440 kilometers.
- 12 m wide crown section to house two 3.5 m wide traffic lanes (one in each direction) and 3.0 m shoulders
- Trumpet type 2 junctions (Tepeojuma and San Félix Rijo).
- IRI of the project 2.5 m/km.
- Viaducts 9.
- Junctions 4.
- PIV's 7 structures.

LEGAL AND FINANCIAL STRUCTURE

Type of Project
  Public / Private
Type of Contract
  State Concession
Term
30 years
Selection Process
International Open Tender
Financing Sources
Private
100 %
MXN
6,500,000,000
USD
380,116,959
Payment Source
Project revenues / Rate
The main source of payment are the tolls collected by the concessionaire.

STATUS

Stage
  Execution
Substage
  Pre-Execution Activities
RELEVANT DATES
Request for proposals/Announcement January 30, 2023
Proposals Reception March 09, 2023
Ruling March 22, 2023
Contract Signing March 31, 2023
Term of the Contract March 31, 2053
Contractor
Mota-Engil México, Desarrollo, Tecnología y Planeación y Metrópolis, Operación y Mantenimiento
Major Contractor’s Shareholders
Mota-Engil

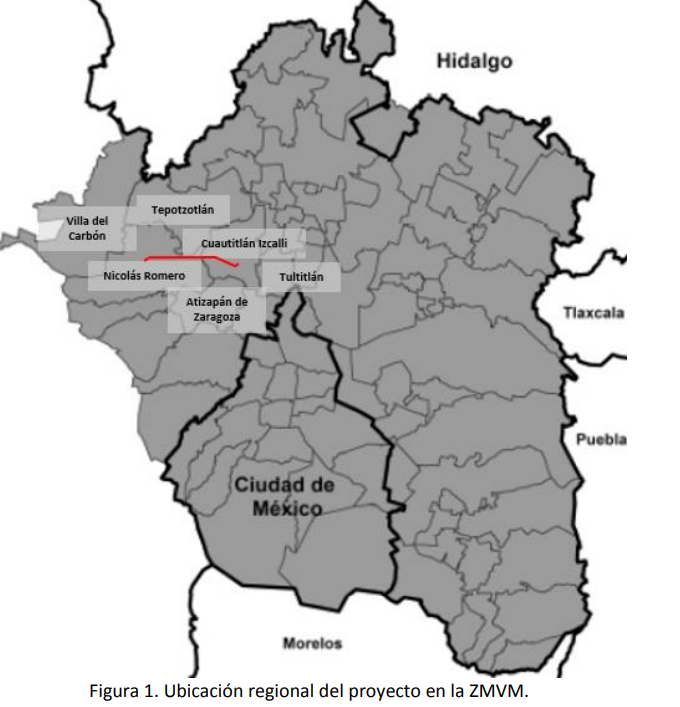

GEOLOCATION

State(s)
State of Mexico

SPONSOR

Responsive image
Entity
State Government
Department
Sistema de Autopistas, Aeropuertos, Servicios Conexos y Auxiliares del Estado de México
Contact
Lic. Alberto Tomás Angulo Lara
E-mail
dg.saascaem@edomex.gob.mx

SUSTAINABLE INFORMATION

PROJECT’S SUSTAINABILITY SUMMARY

The purpose of the Highway is to facilitate road connectivity between urban locations with the primary industrial and service-attracting nodes, reducing massive vehicular flows through the most saturated roads in urban locations, reducing costs and transportation times, and allowing greater accessibility to centers of employment.

* This summary was prepared based on the methodological framework defined by the Inter-American Development Bank (IDB) in the document entitled: “Attributes and Framework for Sustainable Infrastructure”, which is You can check Here.

Additionally, a brief explanation of the methodology and a summary of the questions applied can be consulted in this Document.

ADDITIONAL INFORMATION

Responsive image
Source
State Government

MULTIMEDIA

Gallery
QR Code

REMARKS

This project originates from the submission of an Unsolicited Proposal promoted by Desarrollo, Tecnología y Planeación S.A. de C.V. by writing dated December 12, 2022.
