Project

CONSTRUCTION, OPERATION, MAINTENANCE, CONSERVATION AND EXPLOITATION OF THE ARMERIA-MANZANILLO TOLL HIGHWAY, IN THE STATE OF COLIMA.

Sector: Transport

Last Revision

June 03, 2024
Short Name of the Project:
0090 Armeria-Manzanillo Highway
Type of Investment:
Brownfield
Subsector:
Highways / bridges
Asset (s):
 Highway 37 KM
Contract Currency:
Mexican Pesos MXN
Estimated Investment MXN:

N.A.

Estimated Investment USD:

N.A.

Exchange rate (USD/MXN) used by the Ministry of Finance for the economic plan 2024: $ 17.1
Contract Scope:
  Construction,  Operation,  Maintenance,  Conservation,  Exploitation

DESCRIPTION

ORIGINAL CONCESSION (11/09/1990). construction, operate, exploit, conserve and maintain the 37 km long Armería-Manzanillo toll highway which is part of the Colima-Manzanillo highway; right-of-way is included. The term of the concession is 9 years 3 months.
FIRST MODIFICATION (12/17/1992). Is included the construction and preservation of Salinero II Bridge. The term of the concession is extended to 14 years.
SECOND MODIFICATION (31/05/1994). The Manzanillo bypass of 19 km is included, which is excluded in the Third Addendum. The validity of the concession is modified to 24 years 7 months.
THIRD MODIFICATION (03/02/2006). The Manzanillo bypass is excluded from the concession in order to be toll free. The term of the concession is extended to 30-years.
FOURTH MODIFICATION (11/19/2010). The term of the concession is extended to allow the recovery of the investment made.
FIFTH MODIFICATION (25/02/2011). The term of the concession is extended to 30 years plus an extension from its maturity up to 30 years more.

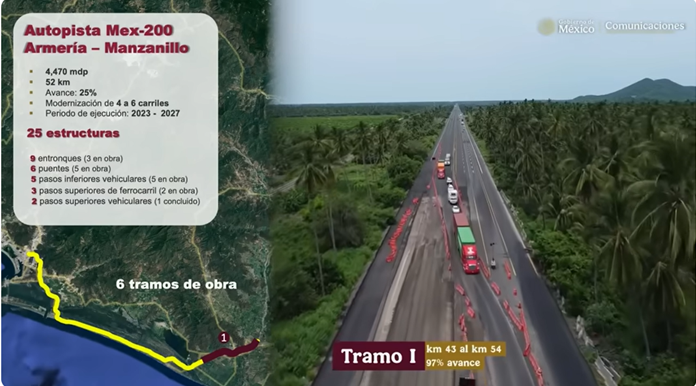

SIXTH MODIFICATION (05/28/2021). The term of the concession is modified to 60 years. Constructive load to construct: Expansion works from 4 to 6 lanes of the highway, Jalipa-Colima elevated disincorporation, Colima-Puerto disincorporation, Expansion from 2 to 4 lanes of the Manzanillo Bypass with returns in Herradura (Stages 1 and 2), Expansion of 2 Highway El Rocío-Highway section. The considerations of the concessionaire are modified.

LEGAL AND FINANCIAL STRUCTURE

Type of Project
  Public / Private
Type of Contract
  Concession
Term
60 years
Selection Process
Public Bid
Payment Source
Project revenues / Rate
The main project´s source of payment are the toll fees collected by the concessionaire.

STATUS

Stage
  Operation
Substage
  > 5 years of operation
RELEVANT DATES
Contract Signing November 09, 1990
Term of the Contract November 08, 2050
Contractor
Promovías Terrestres
Major Contractor’s Shareholders
Promotora y Operadora de Infraestructura

GEOLOCATION

State(s)
Colima

SPONSOR

Responsive image
Entity
Secretaría de Infraestructura, Comunicaciones y Transportes
Department
Dirección General de Desarrollo Carretero
Contact
Fernando Palma Soto / Director General Adjunto de Seguimiento de Concesiones de Autopistas
E-mail
fpalmaso@sct.gob.mx

ADDITIONAL INFORMATION

Responsive image
Source
Secretaría de Infraestructura, Comunicaciones y Transportes
Description
Federal Government entity responsible for promoting adequate transport and communications networks to contribute to services accessibility, and cope with globalization trends.
Responsive image
Source
Secretaría de Medio Ambiente y Recursos Naturales
Description
Federal government entity and sectorial authority responsible for establishing the necessary criteria and instruments to guarantee the protection, preservation, and use of natural resources, by developing an environmental policy that ensures sustainable growth.
ID
06CL2024V0004
Permits, new six-lane bridge
Responsive image
Source
Concessionaire / Related Company
Responsive image
Source
Mexican Stock Exchange

Follow the Project

Leave your e-mail to receive updates on this Project.

 I have read and I accept the Privacy Notice
